Timesheets

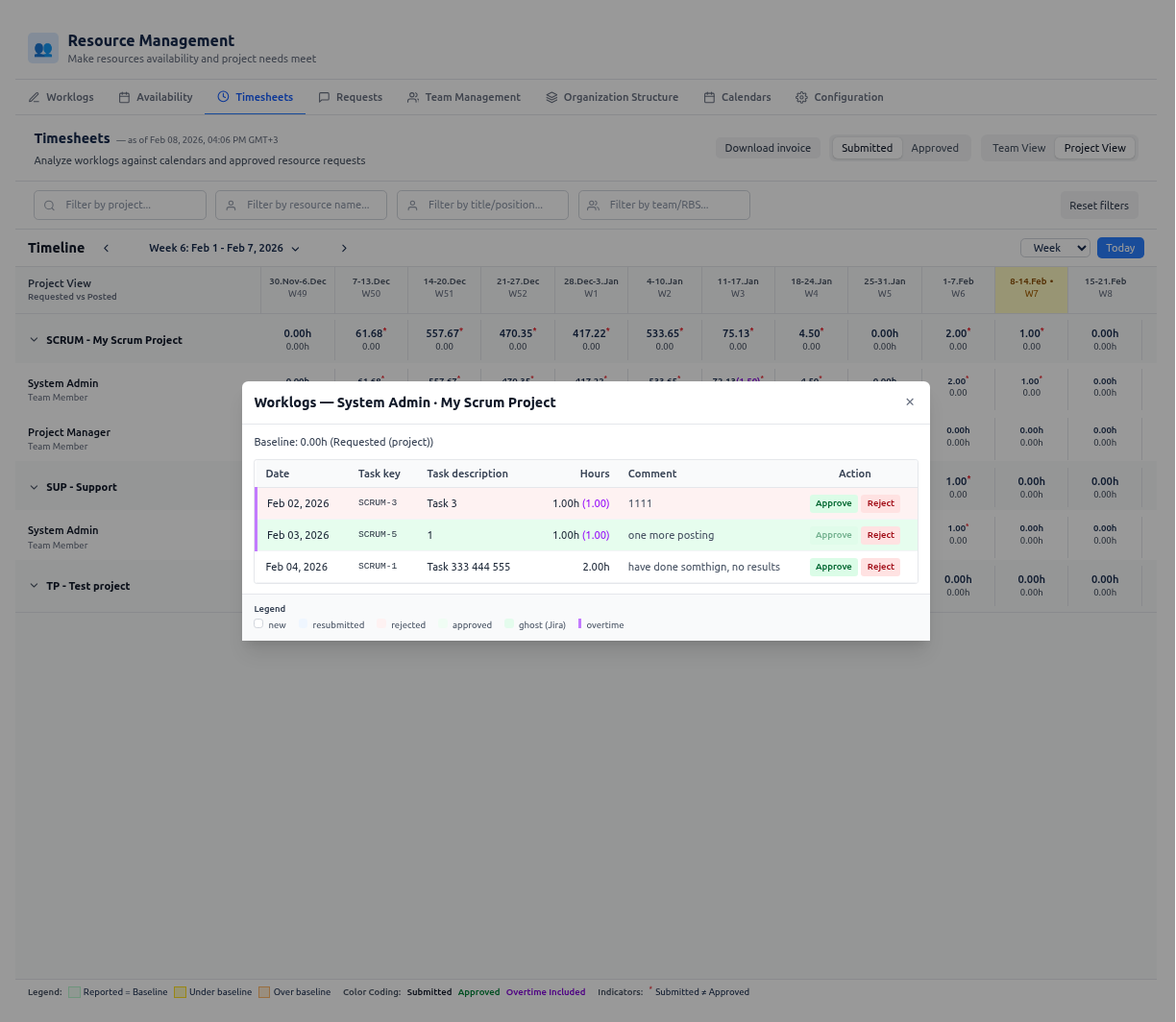

The Timesheets tab shows worklogs (time entries) posted to projects and compares them to a baseline so you can spot gaps and over-reporting. Timesheets become actionable by comparing actuals to smart baselines:
- Team View: Posted hours are compared to available working time from each resource’s effective calendar (working hours, exceptions, availability).
- Project View: Posted hours are compared to time allocated to the project from approved resource requests and assignments.
Color-coded cells highlight when reported hours are above or below the baseline. That supports immediate detection of over-allocation and under-utilization, better compliance and audit readiness, and executive-ready reporting.

Who can see and do what
| Role | Can open the tab? | What they see |
|---|---|---|
| Instance Admin | ✅ | All timesheets. Team View and Project View. Can approve/reject worklogs when approvals are enabled. |
| Resource Management for Jira App Admin | ✅ | Same as Instance Admin (subject to host platform restrictions). |
| Team Manager | ✅ | Team View only. Timesheets for team members in the teams they manage (team → member → project). Can approve/reject worklogs when approvals are enabled. |
| Project Manager | ✅ | Project View only. Timesheets for projects they manage (project → member). Can approve/reject worklogs when approvals are enabled. |
| Team Manager + Project Manager | ✅ | Both Team View and Project View; each view shows only the data for that role. |
| Viewer | ❌ | — |
Only Instance Admin, Resource Management for Jira App Admin, Team Manager, and Project Manager can open the Timesheets tab. Viewer cannot access Timesheets (tab not available).
Who can approve or reject worklogs is controlled by application settings (when worklog approvals are enabled). Typically Project Managers approve worklogs for their projects; Team Managers may have approval rights for their team members’ work.
Interface description
View switch

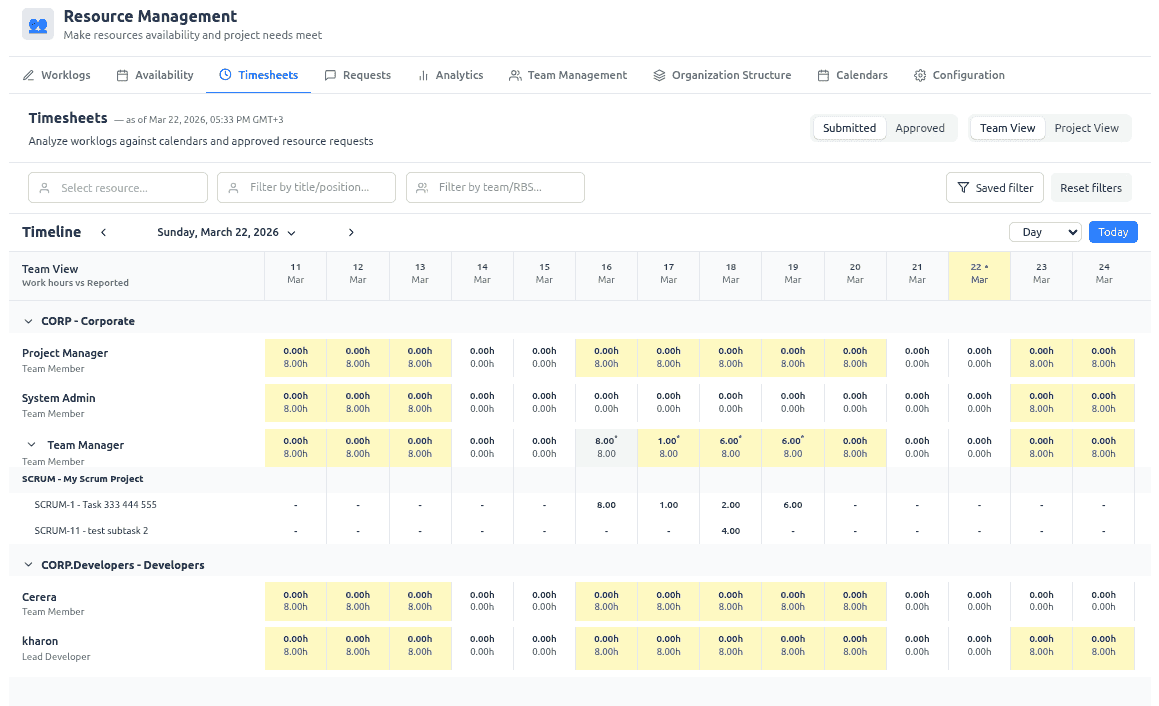

- Team View — Groups data by team → member → project. Baseline = available working time from each resource’s effective calendar. Use it to check whether team members are logging time in line with their capacity (over/under relative to their calendar).
- Project View — Groups data by project → member. Baseline = allocated hours from approved resource requests/assignments. Use it to check whether posted hours match what was allocated to the project.
Only the views allowed for your role are shown. If you have both Team Manager and Project Manager roles, you can switch between Team View and Project View.
Timeline
- Scale — Day, week, or month (quarter is not offered for timesheets to keep data and totals manageable).
- Navigation — Previous/next period, “Today,” and date selector. The current period is highlighted.
- Period columns — Each column is one period (e.g. a day, week, or month). Column headers show the period label and sublabel (e.g. date range).
